You can create Dependency Management Groups only for Batch Optimization.
|

|

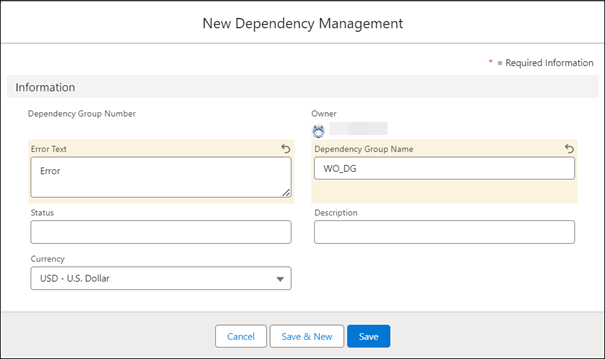

Field
|
Description
|
|---|---|
|
Dependency Group Name
|
Specify a name for the dependency group you are creating.
|
|
Description
|
Specify a description for the dependency group.
|
|
Error Text
|
Enter an error text for the dependency group.
|
|
Status
|
Enter a status.
|
|
Currency
|
Select a currency from the dropdown list.
|
|
|
To define the dependency management group, the Primary Work Order, Secondary Work Order, Time Dependency, and Resource Dependency fields are mandatory.
|
|
Field
|
Description
|
||
|---|---|---|---|
|
Fields marked with * are mandatory.
|
|||
|
Primary Work Order*
|
Specify the work order that is primary in the dependency group you are creating. You can use the lookup option to select the work order.
|
||
|
Secondary Work Order*
|
Specify the secondary work order for the dependency group. You can use the look-up option to select the work order.
|
||
|
Time Dependency*
|
Specify the time dependency you want to enforce between primary and secondary work orders. The following are the time dependency options:
• None: Select this option if you want to create the dependency group only to define a resource dependency.
• Start to Finish: Primary work order must start before secondary work order can finish: Select this option if you want the secondary work order to finish only after the primary work order has started.
• Start to Start: Primary work order must start before secondary work order can start: Select this option if you want the secondary work order to start only after the primary work order has started.
• Finish to Finish: Primary work order must finish before secondary work order can finish: Select this option if you want the secondary work order to finish only after the primary work order has finished.
• Finish to Start: Primary work order must finish before secondary work order can start: Select this option if you want the secondary work order to start only after the primary work order has finished.
• Finish in Unison: Both work orders must finish simultaneously: Select this option if you want both the primary work order and the secondary work order to finish at the same time.
• Start in Unison: Both work orders must start simultaneously: Select this option if you want both the primary work order and the secondary work order to start at the same time.
• Set Arrival Time of Secondary relative to the End Time of Primary: Select this option if you want to set the arrival time for the secondary work order relative to the arrival time of the primary work order.
|
||
|
Resource Dependency*
|
Specify the resource dependency you want to enforce between primary and secondary work orders.
The following are the resource dependency options:
• None: Select this option if you are using this dependency group to create a time dependency, and do not want to specify any resource dependency. However, you can use a dependency group to specify both time and resource dependencies at the same time.
• Same Resource: Select this option if you want the optimizer to assign both the primary work order and the secondary work order to the same technician.
• Different Resource: Select this option if you want the optimizer to assign the primary work order and the secondary work order to two different technicians.
|
||
|
Minimum Time Buffer
|
If you are creating a time dependency group, specify the minimum time buffer from which the time dependency needs to be met.
|
||
|
Minimum Time Buffer Units
|
Select the unit for the minimum time buffer. Available options are minutes, hours, and days.
|
||
|
Maximum Time Buffer
|
If you are creating a time dependency group, specify the maximum time buffer up to which the time dependency needs to be met.
|
||
|
Maximum Time Buffer Units
|
Select the unit for the maximum time buffer. Available options are minutes, hours, and days.
|
||
|
|
If you have selected Finish in Unison or Start in Unison as the time dependency, the time buffers are considered.
|


|
|
• When scheduling the dependency work orders, the optimizer supports the dependencies and schedules them accordingly.
• Dependency is a soft constraint.
|
